A intensive financial literacy bootcamp for newly minted government contractors. It provides practical strategies for managing mobilization cash flow, understanding federal billing cycles, and securing working capital to bridge the 60-90 day payment gap.

Day 45 Payroll ($12,000) & Subcontractor Due ($12,000)
Day 60
Day 60 Payroll Run ($12,000)
Day 75
Day 75 Payroll Run ($12,000)
4 Solvency Diagnosis
At which point in time does Aegis Solutions' bank balance go below $0.00? What is the maximum cash shortfall (the lowest negative point) Aegis experiences before the first payment clears on Day 76? Show calculations.
5 Tactical Command Response
Assume Aegis cannot secure external bank financing. Identify and explain two contract negotiation or operational adjustments Aegis could make with the subcontractor or client to bridge this cash gap.
CAMPUS CADET TRAINING INC. PAGE 2 OF 2
1

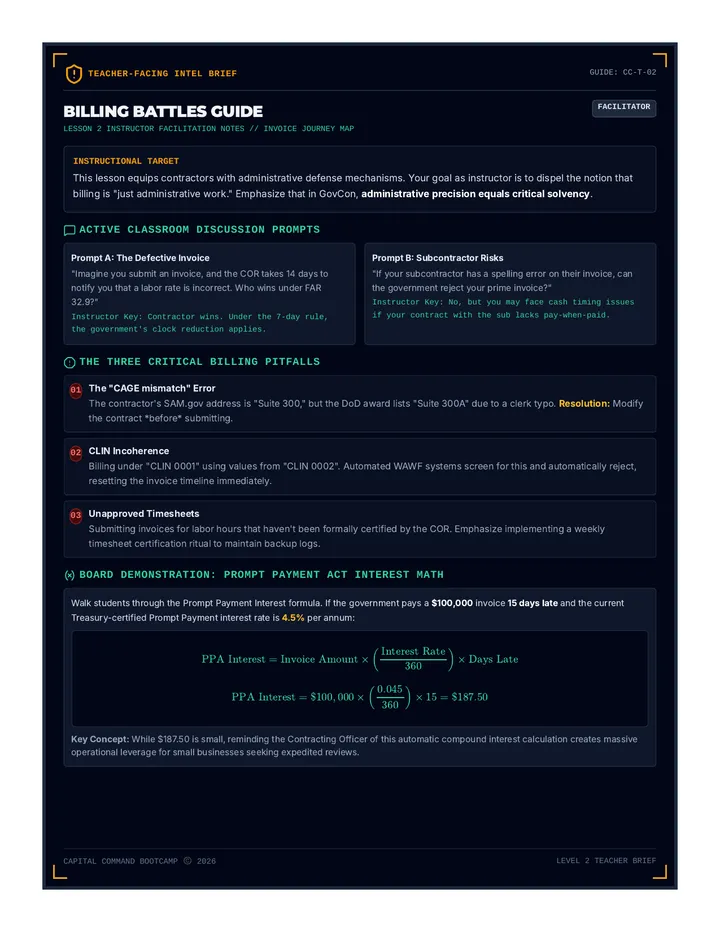

The Pre-Review Routine
Send a PDF draft of your invoice to your COR 5 days BEFORE submitting it in WAWF. Resolve all questions informally first.
2
Timesheet Alignment
Ensure timesheet labor categories, hourly billing rates, and actual payroll matches the compliant accounting rules perfectly.
3
Enforce the PPA Clock
If the government keeps your invoice for more than 7 days without rejection, remind them that proper invoice status is locked.
ACCURACY DRIVES LIQUIDITY
SLIDE 05 / 05
4 Case B: The Scaling Veteran

An established contracting firm, Vanguard Tactical, has a 5-year federal track record, excellent financial books, and a strong relationship with a local commercial bank. They have won a new $1.5M Army contract and need $200,000 to purchase equipment. Which tool is optimal? Contrast this choice with the choice made in Case A.
5 Tactical Rule of Engagement
Define the term "Pay-When-Paid" and describe how incorporating this clause in your agreements with subcontractors acts as a vital internal buffer to protect your company's cash runway.
CAMPUS CADET TRAINING INC. PAGE 2 OF 2
KEY: CC-K-03

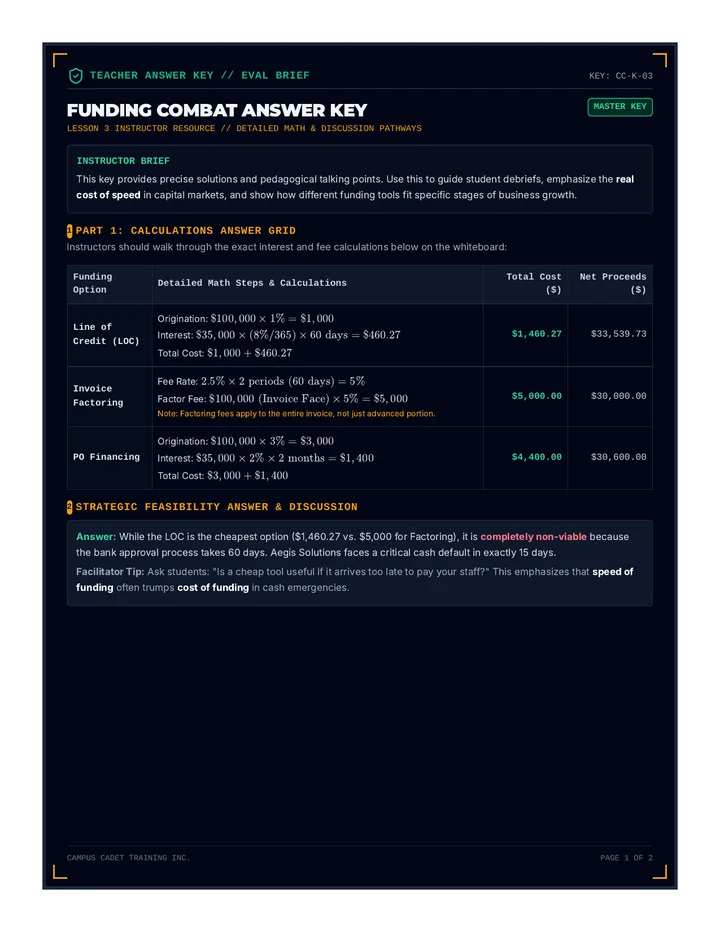

3 Case A: Credit-Challenged Startup Answer
Optimal Option: Invoice Factoring or PO/Mobilization Financing.
Underwriting Rationale: Commercial banks will instantly decline a Line of Credit (LOC) due to the poor credit score (< 600) and short track record (3 months). Factoring and PO finance companies do not evaluate the prime contractor's balance sheet or credit score. Instead, they underwrite the creditworthiness of the federal government agency and verify the validity of the contract award. This makes these tools highly accessible for high-risk GovCon startups.
4 Case B: Scaling Veteran Answer
Optimal Option: Business Line of Credit (LOC) or traditional commercial bank loan.
Contrast Analysis: Because Vanguard Tactical is an established player with solid records, they qualify for a prime rate Line of Credit. It has the lowest interest rate and is highly flexible. They do not need to pay high factoring fees (5% to 6% of contract volume). Factoring should only be used when bank products are unattainable. traditional bank products should always be the ultimate goal.
5 Tactical Rule: Pay-When-Paid Answer
Answer: A "Pay-When-Paid" clause states that the prime contractor is not legally obligated to pay their subcontractors until they receive the corresponding payment from the government.
Buffer Mechanism: It passes the 60-90 day billing cycle risk down to the subcontractor, ensuring that the prime's bank account is never drained to pay for outsourced labor before the government has compensated the prime for that labor.
